Cape Town & Saldanha · Western CapeMarine / Industrial / Workshop / Onsite
Naude Industries / Specialist Procurement / Greenheart Timber
Marine infrastructure supply

Greenheart Timber for Dry Docks

Specialist international procurement and delivery of large-format Greenheart timber for dry dock and marine infrastructure requirements in South Africa.

10 timber sectionsCompleted specialist order
440 × 330 mmHeavy rectangular section
10 metres longLarge-format marine timber
14.52 m³ totalDelivered to the Port of Durban
A complete supply responsibility

From international source to client delivery.

This was not an off-the-shelf timber order.

Naude Industries purchased, imported and delivered ten Greenheart timber sections for dry dock works at the Port of Durban. Each section measured 440 mm × 330 mm × 10 m, requiring specialist sourcing and coordinated handling through to final delivery.

Specialist procurement
International purchasing
Import coordination
Large-format logistics
Port delivery
Marine project support
How the order moved

Specialist material. Managed end to end.

The value was not only finding the timber-it was carrying responsibility for the complete order through to the client.

01

Source

The unusual section size and marine application were matched to an established specialist international supply channel.

02

Purchase

Naude Industries purchased the ten Greenheart timber sections against the confirmed project requirement.

03

Import

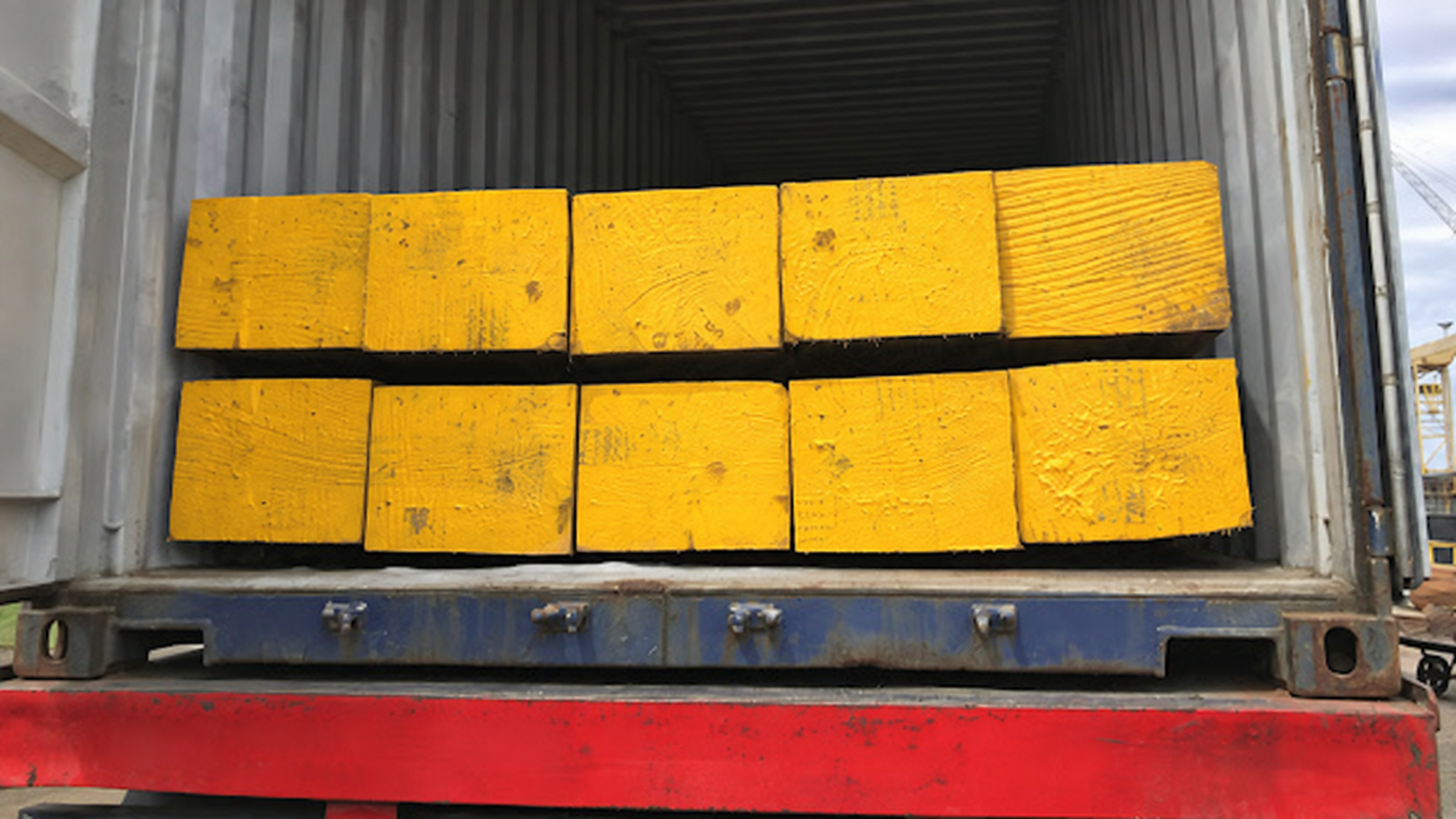

The international shipment and import process were coordinated for the large-format timber order.

04

Deliver

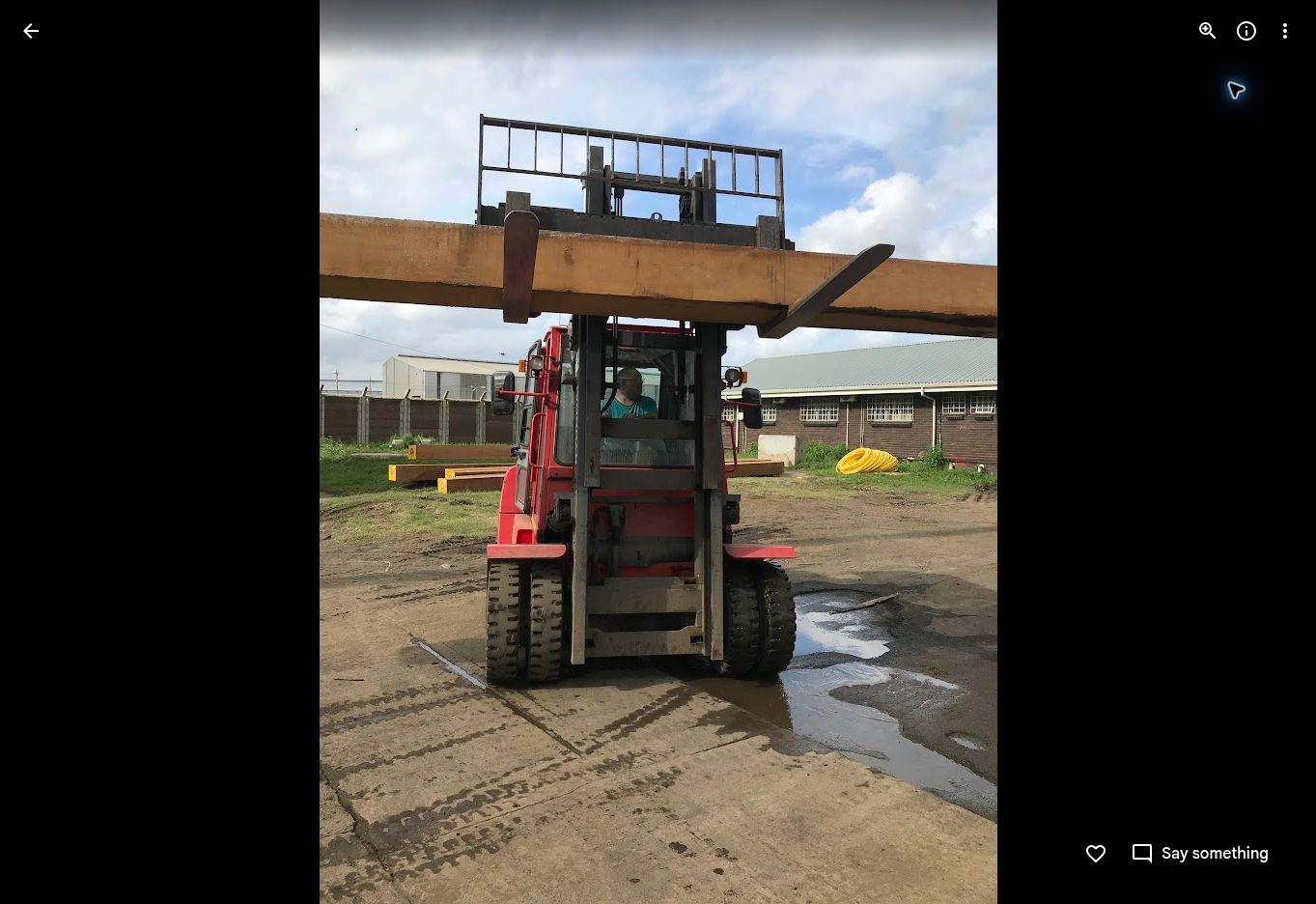

The complete consignment was transported and delivered to the client at the Port of Durban.

Project planning capability

Programme managed before execution.

The client programme was prepared in Microsoft Project to coordinate the complete long-lead supply sequence-from procurement and timber production through shipping, customs handling, transport and final handover.

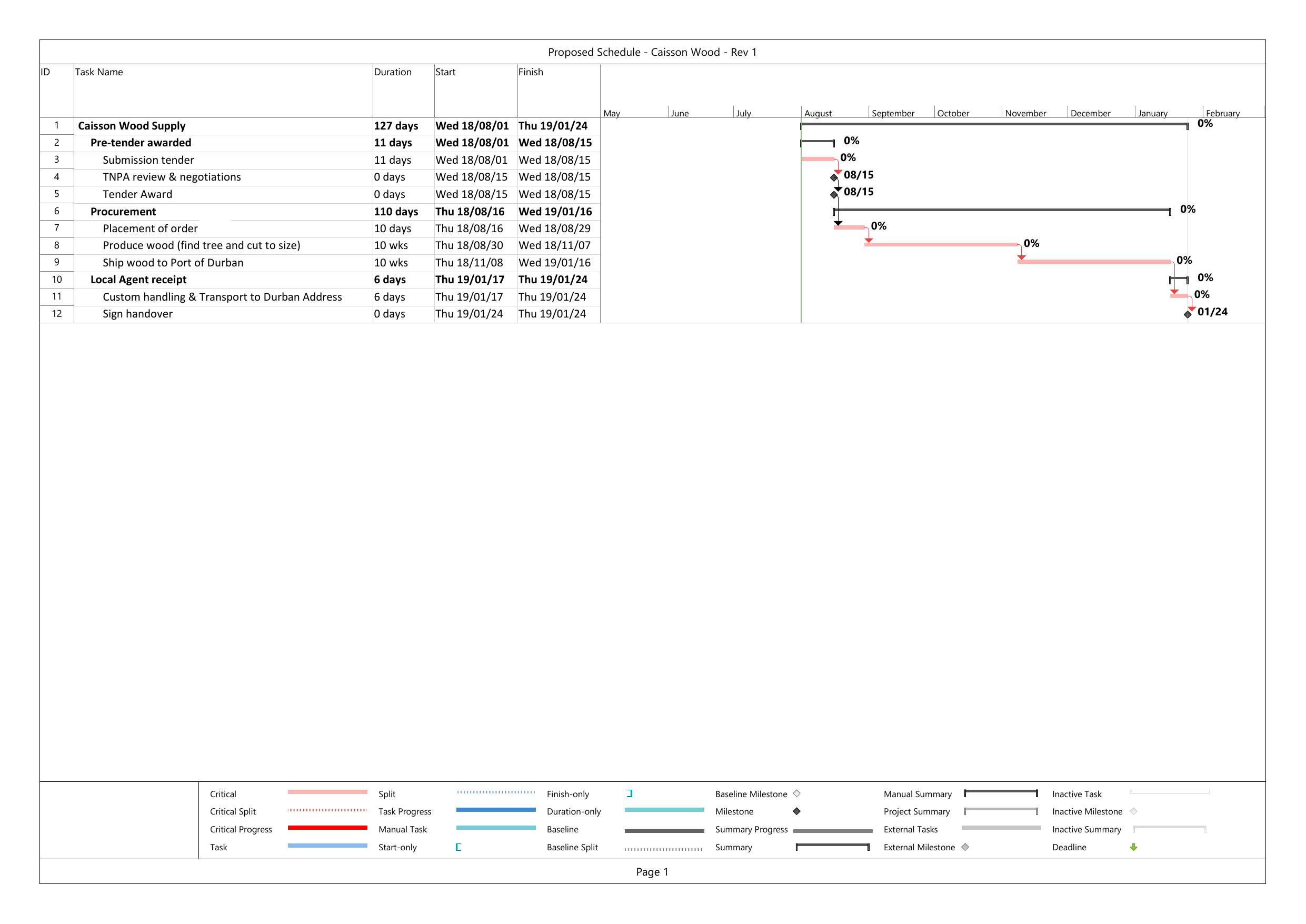

Microsoft Project programme for the Greenheart timber supply showing procurement, production, shipping, customs handling and client handover

Submitted project programme · Supplier location withheld · Select the schedule to view it at full size.

Completed supply reference

Large-format timber. Proven delivery.

The completed project demonstrates Naude Industries' ability to manage unusual marine procurement requirements beyond standard workshop supply.

MaterialSpecialist Greenheart timber
Quantity10 individual sections
Section size440 mm × 330 mm
Individual length10 metres per section
Total timber volumeApproximately 14.52 m³
Delivery destinationClient at the Port of Durban

The supplier, country of origin and commercial source details remain confidential. New requirements are assessed according to dimensions, quantity, specification, availability and delivery programme.

Common questions

Greenheart timber enquiries.

Can Naude Industries source Greenheart timber for dry dock work?

Naude Industries has previously purchased, imported and delivered a large-format Greenheart timber order for dry dock works. New enquiries are assessed against the required dimensions, quantities, specification and programme.

What information is needed for an enquiry?

Provide the required section dimensions, lengths, quantities, intended application, delivery location and required delivery date. Include the applicable timber or project specification where available.

Do you disclose the overseas supplier?

No. Supplier identity and country-of-origin details form part of Naude Industries' confidential commercial supply chain.

Can delivery be included?

Yes. The previous order covered purchasing, importing and final delivery to the client. The logistics scope for a new order will be confirmed during quotation.

Send the timber sizes, quantities and delivery requirement for a specialist supply assessment.

Start a Greenheart enquiry →
